Skip to content

4Kp30 Multi-Sensor Camera with AI Inference Solution System Example Design for Agilex™ 5 Devices - ISP and AI IP Design Functional Description

The 4Kp30 Multi-Sensor Camera with AI Inference Solution System Example Design demonstrates a practical glass-to-glass smart camera solution using Altera®'s FPGA AI Suite, and standard Connectivity and Video and Vision Processing (VVP) Suite IP Cores available through the Quartus® Prime Design Software (QPDS).

The design ingests the video input through industry-standard MIPI directly connected to each sensor. The selected sensor video is then processed through the Image Signal Processing (ISP) pipeline. The ISP output feeds both the AI pipeline and the DisplayPort (DP) output pipeline. The AI pipeline downscales the video input suitable for the inference model which runs on the FPGA AI Suite IP. The design runs an embedded Linux Software Application (SW App) on the Hard Processor System (HPS). The HPS (along with a Nios® V soft CPU) performs the AI functions to interact with the AI IP, including loading the inference model, starting inferences, and reading inference results. It also processes the results to generate an inference results overlay video which is blended over the top of the ISP output video. The SW App also provides real time camera functions like auto white balance (AWB) and auto exposure (AE).


The following block diagram shows the main components and subsystems of the Camera Solution System Example Design. Note that where an IP has been used multiple times, its instance number is shown (bottom right corner of the IP) and can be used for identification in the detail that follows.

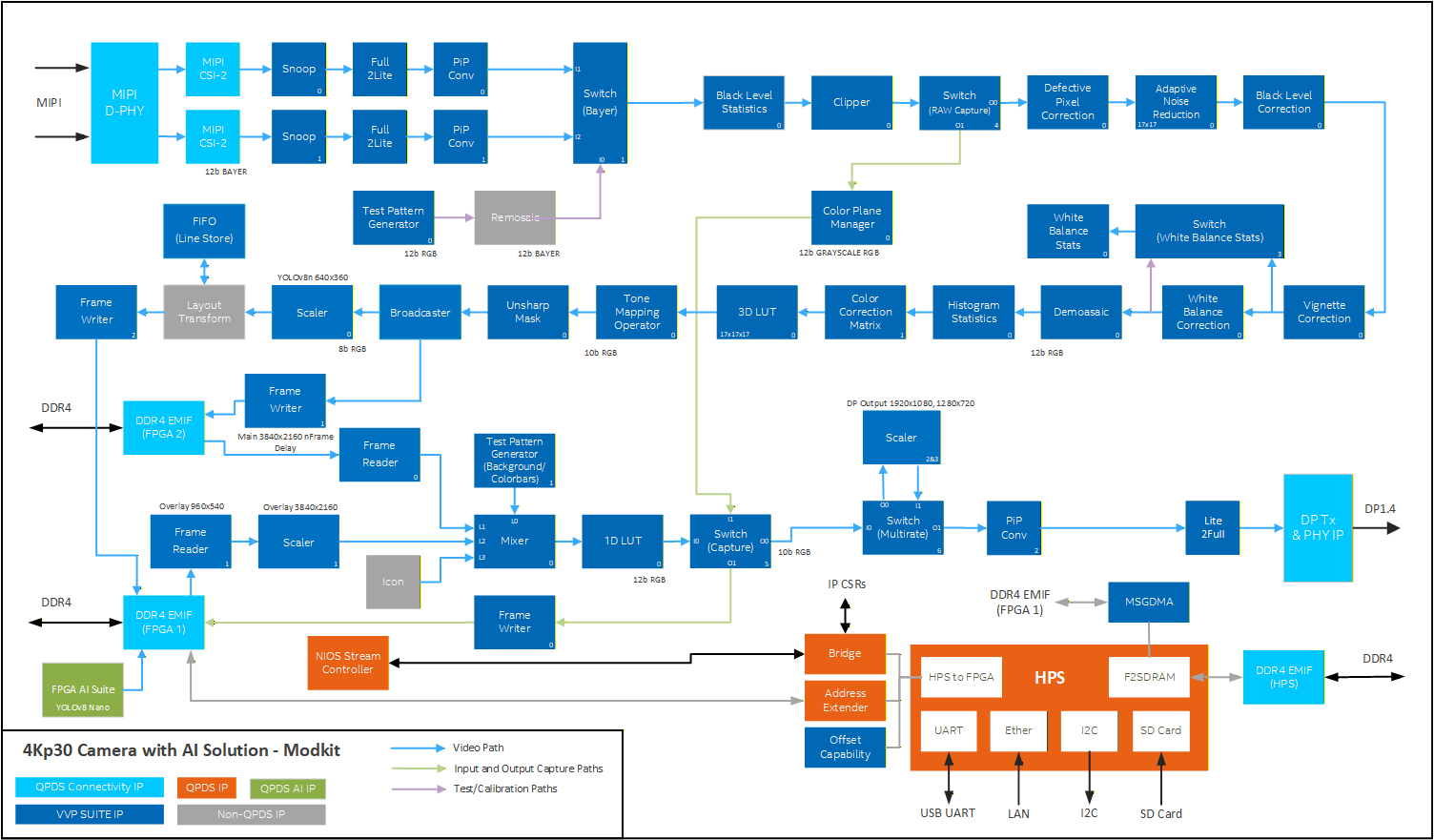

top-block-diagram.

4Kp30 Multi-Sensor Camera with AI Inference Solution System Example Design for Agilex™ 5 Devices Top Block Diagram


MIPI Ingest

The Framos FSM:GO IMX678 optical sensor module with PixelMate MIPI-CSI-2 connection uses a 4-lane MIPI interface. The sensor is a Sony Starvis2 8MP IMX678 that outputs a Color Filter Array (CFA) image (also known as a Bayer image) and can support up to a UHD 4K resolution at 60 FPS.

A CFA is typically a 2x2 mosaic of tiny colored filters (usually red, green, and blue) placed over a monochromatic image sensor to effectively capture single color pixels. The CFA typically contains twice the number of green filters to align with human vision which is more sensitive to light in the yellow-green part of the spectrum. The example below shows a typical RGGB (Red, Green, Green, Blue) CFA pattern which repeats over the entire image (an 8x8 image in this example). Pixels arrive left to right, top to bottom, as alternating Red and Green pixels on the first line, and then alternating Green and Blue pixels on the next line. This pattern repeats on the next pair of lines, and so on.


bayer_diagram.

8x8 RGGB Color Filter Array (Bayer) Image Example


Using single color pixels reduces the overall bandwidth requirements of the sensor. A demosaic algorithm can be used to rebuild the full color image. Note that in the CFA domain, 4 color channels actually exist (in our example they are Red, Green1, Green2, and Blue). Therefore, it can be seen that any given pixel belongs to just one of these color channels when processing. Each color channel is sometimes referred to as a CFA phase.

The Altera® MIPI D-PHY IP interfaces the FPGA directly to 2 Framos optical sensor modules via Framos connectors on the Modular Development Kit Carrier Board and PixelMate CSI-2 Flex-Cables. The design showcases a 4K (3840x2160) sensor that can process images up to 60 FPS using 12-bit Bayer pixel samples. The MIPI D-PHY is configured for 2 links (one per sensor) of x4 lanes at 1782 Mbps (which provides sufficient bandwidth) with no skew calibration and non-continuous clock mode. Each sensor module has additional pins, including Power on Reset, Master/Slave mode, as well as sync signals and a slave I2C interface for control and status. The MAX10 device on the Modular Development Kit Carrier Board drives some of these signals which can be controlled via the FPGA using an additional I2C interface. All the I2C interfaces are connected to the HPS I2C controllers. The SW App auto-detects and configures all of the detected sensor modules, including a GMSL3 link in MIPI0 if being used. The FPGA AI Suite IP resource has been limited to achieve a maximum inference rate of 30 FPS. Therefore, the sensor module output is configured to limit it to 30 FPS.

The design connects an Altera® MIPI CSI-2 IP to each of the MIPI D-PHY IP Rx links using a 4-lane 16-bit PHY Protocol Interface (PPI) bus. The design configures each CSI-2 IP output at 4 Pixels In Parallel (PiP) using a 297MHz clock and minimal internal buffering. Since all ISP IP only support VVP AXI4-S Lite protocol, A VVP Protocol Converter IP is used on each CSI-2 IP output.

To reduce FPGA resources, a VVP PIP Converter IP is then used to reduce the PIP from 4 to 1 (which still provides sufficient bandwidth to process the video image). The sensor modules cannot be stalled. So the PIP Converter contains 2 lines of video buffer to accommodate small amounts of back-pressure from downstream IPs.


ISP Ingest


isp_ingest.

ISP Ingest


The Input TPG IP (Instance 0) allows you to test the ISP parts of the design without a sensor module input. It uses the VVP Test Pattern Generator IP and a non-QPDS IP called Remosaic (RMS) (supplied with the source project). The TPG has an RGB output which cannot be processed by the ISP IP as they only support CFA images. The RMS is used to convert the RGB image into a CFA image by discarding color information for pixels based on the CFA pattern supported by the sensor. The TPG features several modes, including SMPTE color bars and solid colors. The Bayer Switch - VVP Switch IP (Instance 1), is used to select the Input source.

Related Information

Test Pattern Generator IP
Switch IP



ISP Processing

This section summarizes notable ISP processing functions and IPs used in the Camera Solution System Example Design:


Black Level Statistics

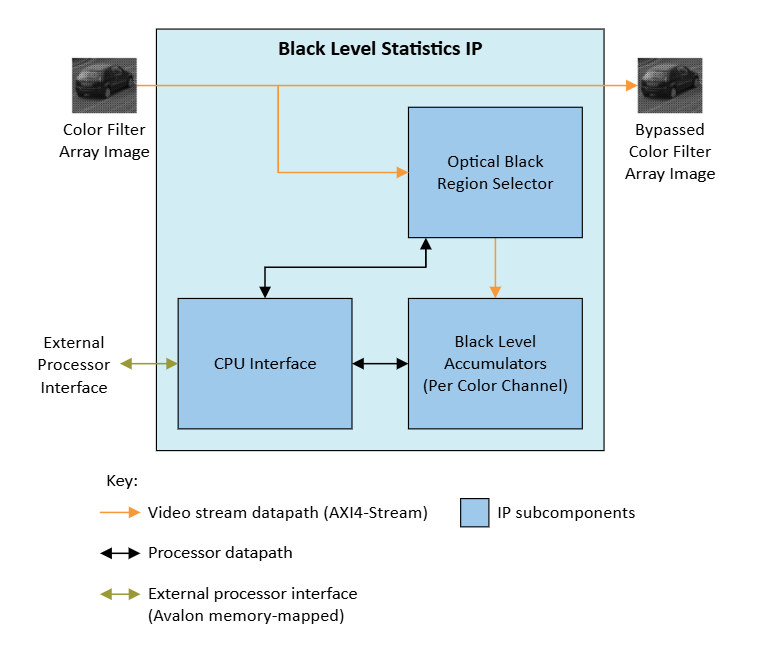

BLS_diagram.

Black Level Statistics Block Diagram


The Black Level Statistics (BLS) IP accumulates pixel values in a Region of Interest (ROI), which is usually associated with a shielded area of an imaging sensor called an Optical Black Region (OBR). The SW App, using these statistics, may choose to keep the sensor's black-level value constant and compensate for any deviations caused by various external factors like temperature changes, voltage drifts, or aging.

The BLS calculates statistics across an OBR of the 2x2 CFA input from the sensor. The IP has dedicated accumulators for each CFA channel that calculates 4 independent pixel sums. The SW App uses the BLS IP to set the offset and scalar coefficients of the Black Level Correction (BLC) IP. The BLS passes the input image to its output unchanged.

Note that although the hardware design includes BLS IP as part of the video pipeline, the SW App does not configure the imaging sensor and the MIPI connectivity IPs to pass the OBR for processing the statistics real time. The SW App reads these statistics as part of a hidden and unsupported offline calibration flow.

Related Information

Black Level Statistics IP


Clipper

The Clipper IP crops an active area from an input image and discards the remainder. The SW App may choose to use this IP to discard unwanted regions of the video like OBR from the sensor input or perform digital zoom. Currently, the SW App configures the sensor to output 4K video at the input, therefore it configures the Clipper IP to bypass the input image.

Related Information

Clipper IP


Defective Pixel Correction

The Defective Pixel Correction (DPC) IP removes impulse noise associated with defective pixels in the sensor image. Such impulse noise is usually the result of defective pixel circuitry within image sensor for a given pixel, and it manifests itself in those pixels to respond to light drastically differently compared to their neighboring pixels. The DPC IP operates on 2x2 Bayer CFA images, identifying defective pixels using a configurable non-linear filter, and then corrects them.


DPC_diagram.

Defective Pixel Correction Block Diagram


The DPC IP works on a 5x5 pixel neighborhood. The IP gathers the 9 pixels of the same color channel closest to the current pixel (the center pixel in the neighborhood) and sorts them according to their pixel values. A non-linear filter calculates a corrected pixel value from the sorted group of pixels depending on the sensitivity setting.

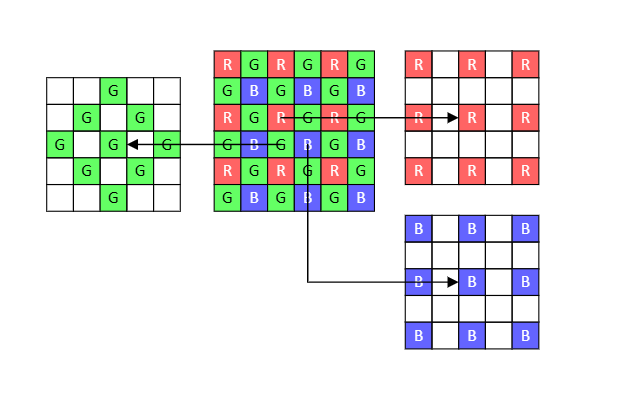

DPC_Bayer_CFA_diagram.

A Bayer CFA for a 6x6 section of an image and an example pixel neighborhood for green, red, and blue pixels


The DPC IP dynamically identifies and filters defect pixels and does not support static defective pixel correction of predetermined pixels. When you set the sensitivity level to the weakest value, the pixel value is altered only if its original value falls outside the value range of its whole pixel neighborhood. As the sensitivity increases the IP approximates a class of median filter.

Related Information

Defective Pixel Correction IP


Adaptive Noise Reduction

The Adaptive Noise Reduction (ANR) IP is an edge-preserving smoothing filter that mainly reduces the independent pixel noise of an image. The IP operates on 2x2 Bayer CFA images.

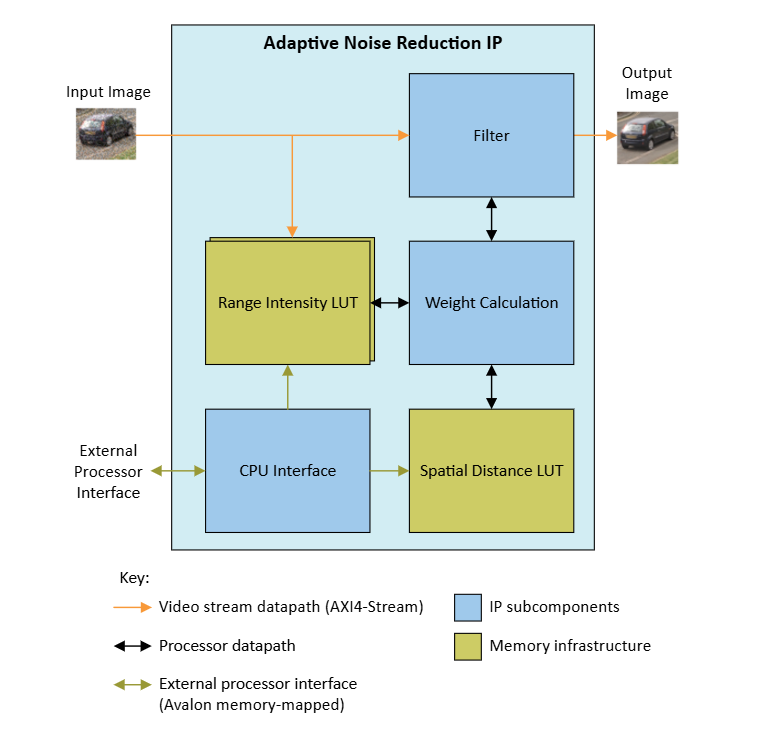

ANR_diagram.

Adaptive Noise Reduction Block Diagram


The ANR IP uses a spatial weighted averaging filter that analyzes the scene and correlates similar pixels dynamically while generating the weights on the fly. The IP utilizes two LUTs when correlating the pixels, one for correlating pixel intensities and the other for correlating the spatial distance between the pixels.

The design provides the intensity range LUT pre-calibrated offline using the difference in noise level between two video images with identical content but different temporal noise. The noise level is a function of the sensors analog gain. Therefore, the calibration file contains a table of LUT parameters for a range of sensor analog gain settings. Using a LUT allows you to program different denoising strengths across the pixel intensities. For example, you may opt for stronger denoising of dark content to reduce shadow noise more aggressively while preserving the details on the mid-tones and highlights.

The spatial distance LUT is used to make the ANR more versatile. It is programmed to create a weight distribution from the center pixel to the neighboring pixels. Traditional distributions like a Hamming or Hanning window can be used to reduce ringing artifacts, or the same value entries can be used for a rectangular distribution to maximize denoising capability. By default, the software configures a Gaussian distribution into the spatial distance LUT.

Related Information

Adaptive Noise Reduction IP


Black Level Correction

The Black Level Correction (BLC) IP operates on a 2x2 CFA input image and adjusts the minimum brightness level of the image, ensuring an actual black value is represented by the minimum pixel intensity. A camera system typically adds a pedestal value as an offset to the image at the sensor side. Artificially increasing black level creates foot room for preserving noise distribution of the black pixels and prevents artifacts in the final image. The design positions the BLC IP after the ANR IP where the noise is reduced as much as desired.


BLC_diagram.

Black Level Correction Block Diagram


The BLC IP subtracts the pedestal value from the input video stream and scales the result back to the full dynamic range. The scaler part of BLC multiplies the pedestal remover value by the scaler coefficient, clipping to the maximum output pixel value should the calculation overflow.


BLC_Function_diagram.

BLC Function


The SW App sets the pedestal and scaler coefficients for each of the 2x2 CFA color channels dynamically during runtime. These values can be pre-calibrated, or calculated dynamically from statistics obtained from the BLS IP using OBR of the sensor. You can configure the BLC IP to reflect negative values around zero or clip them to zero.

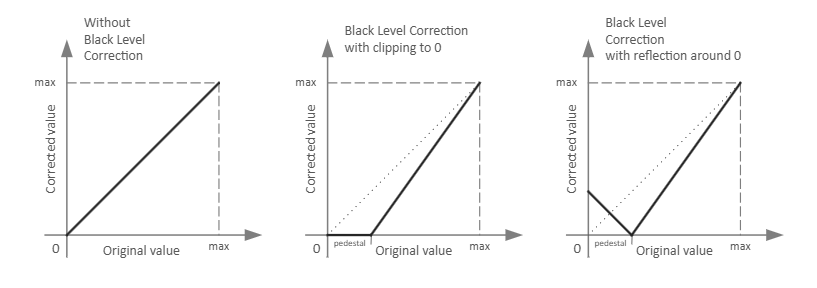

BLC_RAZ_diagram.

Effects of Reflection Around Zero


Note that for this design, the SW App provided does not utilize the BLS IP to read the OBR of the sensor and relies on pre-calibrated coefficients as a function of analog gain of the sensor.

Related Information

Black Level Correction IP


Vignette Correction

The Vignette Correction (VC) IP compensates for non-uniform intensity across the image caused by uneven light-gathering limitation of the sensor and optics. In the usual case, the non-uniformity can be caused by lens geometry transforms such as zoom, aperture, etc., where the center of the lens gathers more light compared to the outer regions. The VC IP corrects uniformity using a runtime mesh of coefficients and interpolating coefficients for any given pixel.

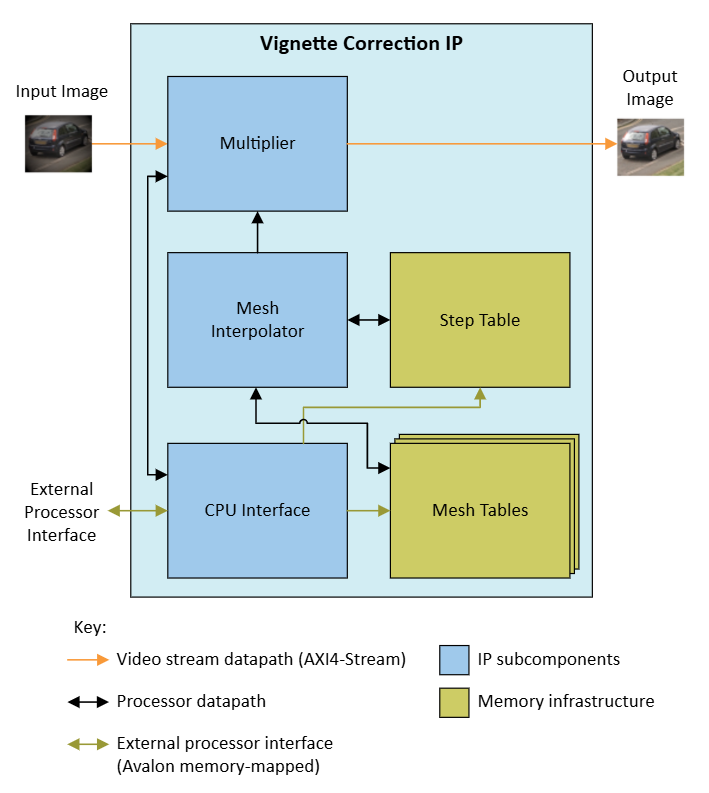

Vignette_diagram.

Vignette Correction Block Diagram


The VC IP uses a rectangular mesh of coefficients to adjust the pixel intensities across an image, therefore tuning out vignetting and other sensor non-uniformities. The VC IP operates independently on the 4 color channels of the 2x2 CFA input image. For all color channels, you may calculate the mesh coefficients with a calibration process in a controlled imaging environment and configure the SW App to write them to the VC IP. The precision of a mesh coefficient is fixed-point unsigned 8.11, with 8 integer bits and 11 fractional bits. The mesh divides the image into rectangular zones, with mesh points residing at the corners of the zones. For each pixel, the IP selects the 4 mesh points corresponding to the corners of the pixel's zone and interpolates them using the distance from the pixel location to the mesh points. A multiplier scales the input pixels using this interpolated coefficient.

Note that the vignetting effect is very low for the sensor module used in this design, therefore, the design does not contain a pre-calibrated mesh of coefficients.

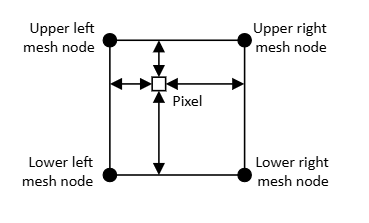

Vignette_Mesh_Zone_diagram.

A Mesh Zone with a Pixel of Interest


Related Information

Vignette Correction IP


White Balance Statistics

WBS_diagram.

White Balance Statistics Block Diagram


The White Balance Statistics IP (WBS) operates on a 2x2 Bayer CFA image and calculates red-green and blue-green ratios within a Region of Interest (ROI). The ROI is divided into 7x7 zones, and the WBS calculates independent statistics for all 49 zones. The SW App uses the WBS to set the White Balance Correction IP.

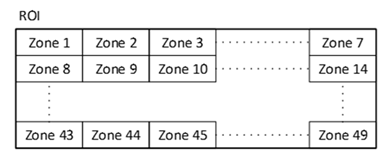

WBS-packing-order-diagram.

Packing Order of the Zones within a Region of Interest


Each 2x2 Bayer region creates a virtual pixel from grouping 4 pixels. The IP then calculates a red-green and a blue-green ratio for each virtual pixel within the ROI.

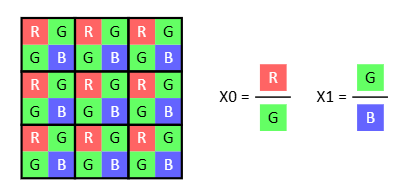

WBS_example_diagram.

Example of ratio calculation for 2x2 virtual pixels for a 6x6 Section of Image


The WBS IP checks both ratios against runtime programmable lower and upper range thresholds and increments a zone virtual pixel count only if both ratios fall between their respective threshold values. If at least one of the ratios is out of range, the IP discards both ratios for that 2x2 virtual pixel and therefore do not contribute to the final statistics of that zone. Ratios of all virtual pixels that are not marked out of range are accumulated, and along with the zone virtual pixel count are transferred to the zone memory at the end of the zone.

The SW App reads each zone memory and calculates an average ratio by dividing the accumulated ratio by the virtual pixel count. If the number of counted pixels is too low, it indicates a zone with mixed content and is therefore unsuitable for inclusion in calculating white imbalance of the image. The Auto White Balance (AWB) algorithm is a feedback loop inside the SW App that continuously reads the white balance statistics and guesses the color temperature of the image scene.

The WBS IP passes its input image to its output unchanged.

Related Information

White Balance Statistics IP


White Balance Correction

The White Balance Correction (WBC) IP adjusts colors in a CFA image to eliminate color casts, which occur due to lighting conditions or differences in the light sensitivity of the pixels of different color. The IP ensures that gray and white objects appear truly gray and white without, unwanted color tinting.


WBC_diagram.

White Balance Correction Block Diagram


The WBC IP multiplies the color channels of a 2x2 CFA input image by scalar coefficients per color channel, clipping to the maximum output pixel value should the calculation overflow.

The design provides a table of WBC scalars pre-calibrated for the sensor for a range of color temperatures. The white balance algorithm in the SW App uses color temperature information of the scene to look up WBC scalars from the calibration table and configures the WBC IP over the Avalon® memory-mapped interface. The SW App uses AWB to guess the color temperature in automatic mode. The SW App also supports many fixed color temperature options.

Related Information

White Balance Correction IP


Demosaic

Demosaic_diagram.

Demosaic Block Diagram


The Demosaic IP (DMS) is a color reconstruction IP for converting a 2x2 Bayer CFA input image to an RGB output image. The DMS interpolates missing colors for each pixel based on its neighboring pixels.


Demosaic-example-diagram.

An example of a 2x2 RGGB Bayer Color Filter Array (for an 8x8 pixel section of the image)


The DMS analyzes the neighboring pixels for every CFA input pixel and interpolates the missing colors to produce an RGB output pixel. The IP uses line buffers to construct pixel neighborhood information, maps the pixels in the neighborhood depending on the position on the 2x2 CFA pattern, and interpolates missing colors to calculate the RGB output.

Related Information

Demosaic IP


Histogram Statistics

The Histogram Statistics (HS) IP operates on RGB images. It analyzes the pixel values for every frame to collects data to form a histogram of light intensity.

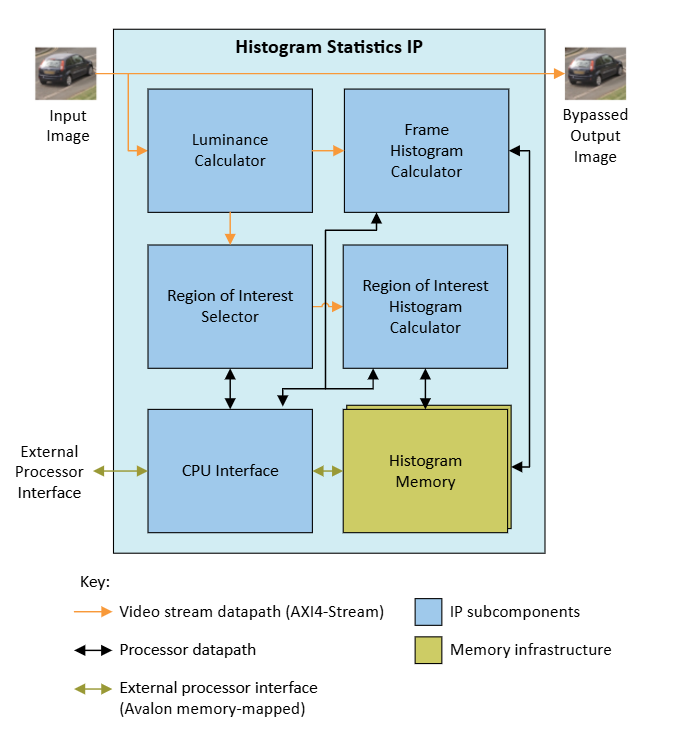

HS_diagram.

Histogram Statistics Block Diagram


The HS IP calculates two light intensity histograms on the RGB input image - a whole image histogram and a ROI image histogram. The RGB to intensity conversion is performed according to the ITU-R BT.709 standard.

The Automatic Exposure (AE) algorithm is a feedback loop in the SW App that guesses the optimum exposure of the scene. It continuously reads the HS IP and guesses whether the capture is underexposed or overexposed and adjust camera sensor exposure settings accordingly.

The HS IP passes its input to its output unmodified.

Related Information

Histogram Statistics IP


Color Correction Matrix

The Color Correction Matrix (CCM) functionality is provided by the VVP Color Space Converter (CSC) IP. A CCM correction is necessary to untangle the undesired color bleeding across CFA color channels on the sensor. This is mainly caused by each colored pixel being sensitive to color spectrums other than their intended color.

The design configures the CSC IP to multiply the input RGB values of each pixel with a 3x3 CCM to obtain the color corrected output RGB values.

The design provides a table of CCM coefficients pre-calibrated for the sensor for a range of color temperatures. The AWB algorithm in the SW App uses color temperature information of the scene to look up the CCM coefficients from the calibration table and configures the CSC IP over the Avalon® memory-mapped interface. The SW App uses AWB to guess the color temperature in automatic mode. The SW App also supports many fixed color temperature options.

The SW App also provides many post-processing options to modulate the CCM coefficients for adding an artistic effect on top of the pre-calibrated accurate representation of the scene.

Related Information

Color Space Converter IP


3D LUT

The 3D LUT IP maps an image's color space to another using interpolated values from a lookup table.

Typical applications include:

  • Color space conversion
  • Chroma keying
  • Dynamic range conversion (standard to high and high to standard)
  • Artistic effects (sepia, hue rotation, color volume adjustment, etc.)

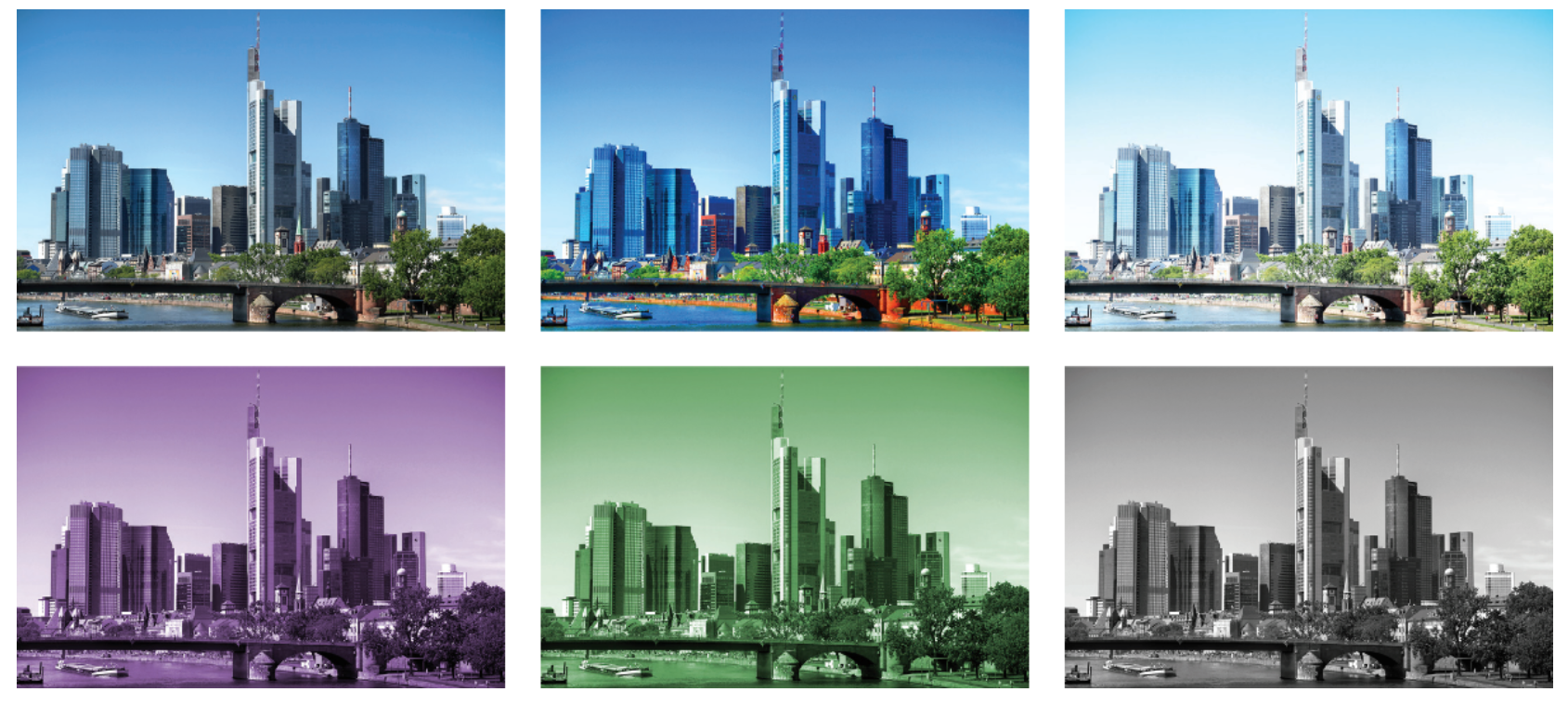

3DLUT_colour_transform_examples_diagram.

3D LUT Color Transform Examples (From top left to right: original, saturation, brightness increase, colorize (purple), colorize (green), desaturation)


3DLUT_diagram.

3D LUT Block Diagram


The 3D LUT uses the most significant bits (MSBs) of the 3 RGB color component inputs to retrieve data values from the LUT and the least significant bits (LSBs) to interpolate the final output value. The SW App connected to the Avalon® memory-mapped interface handles runtime control and LUT programming.

The example design uses 2 back to back 3D LUT IPs to support combinations of conversions and will be application specific. If a 3D LUT isn't required, it can be placed in bypass mode. The output of the final 3D LUT IP is reduced to 12-bits.

Generating LUT Files

You are responsible for sourcing or generating LUTs for the example design. LUTs are generally developed based on input (optical system, sensor, ISP, etc.) and display parameters. Various tools are available under open-source licenses to produce LUTs. One such tool is LUTCalc, which can be used online. When using it to generate LUTs for the 3D LUT IP, ensure that:

  • The LUT is set to 3D
  • Size matches the 3D LUT IP parameters (i.e. 17, 33, or 65 cube)
  • Input and Output Range are 100%
  • LUT Type is "General cube LUT (.cube)"

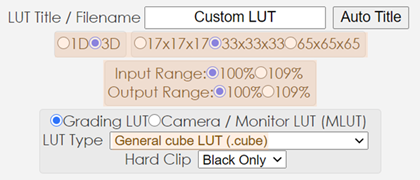

3DLUT-LUTCalc-format-settings-diagram.

LUTCalc Format Settings


In general, any LUT file used with this example design must follow these formatting conventions:

  • RGB component order
  • Components change first from left to right, i.e., R first, G second, B third
  • The data type must match the IP GUI parameter and may either be:
    • normalized fixed- or floating-point numbers between 0.0 to 1.0
    • integers between 0 and 2LUT_DEPTH-1 (for example, 10-bit: 0 to 1023)
  • The data type must be the same for the whole file

Related Information

3D LUT
3D LUT IP
LUTCalc GitHub page


Tone Mapping Operator

The Tone Mapping Operator (TMO) IP implements a tile-based local tone mapping algorithm. It improves the visibility of latent image details and enhances the overall viewing experience.


TMO_example_diagram.

Before (left) and after (right) TMO is applied to an example image


TMO_diagram.

TMO Block Diagram


The luminance extractor converts the RGB input to LUMA. The image statistics calculator uses LUMA to calculate a set of global and local statistics regarding the contrast of the input image over a 4x4 grid. The LUT generator software runs on an embedded Nios® V CPU which analyzes the statistics, generates a set of mapping transfer functions, and converts them to LUTs. The contrast enhancement engine applies mapping transfer functions locally for better granularity. The image enhancer combines the information and calculates a set of weights that are applied to the input to generate the contrast-enhanced output. Since the following VVP USM IP only support 10-bits color, the output of the TMO is reduced down to 10-bits using a VVP Pixel Adapter IP.

The TMO does not use image buffers and therefore the statistics collected from the previous image are used to enhance the current image.

The SW App configures the TMO IP over the Avalon® memory-mapped interface.


Unsharp Mask Filter

The Unsharp Mask (USM) IP applies a sharpening algorithm to the input image by implementing an unsharp mask filter.

The IP firstly converts the RGB input to LUMA. The LUMA input is then passed through a low-pass Gaussian blur filter. The IP subtracts the blurred input from the original LUMA input to generate a high frequency component. A strength scaler is applied to the high frequency component which is then used to scale the input RGB image to generate the output RGB image.

The unsharp mask has an agent Avalon® memory-mapped interface to allow runtime control for changing the sharpening strength. You can configure a positive or negative strength value for sharpening or blurring the image. Setting the strength to 0 is equivalent to bypass i.e. passing the input to the output unmodified.

Related Information

Unsharp Mask IP


AI Processing

This section summarizes notable AI processing functions and IPs used in the Camera Solution System Example Design:

AI Main Frame Buffer

The AI Main Frame Buffer is required to buffer the 4K ISP output image while the AI inference occurs using a copy. The delay in the buffer is equal to the time taken to perform the inference and generate an inference result overlay image.


ai_main_frame_buffer.

AI Main Frame Buffer


The buffer is generated using a VVP Frame Writer IP, a VVP Frame Reader IP, and an external DDR4 SDRAM (via an EMIF). Note that the Main Frame Buffer uses the second FPGA DDR4 SDRAM which increases the amount of bandwidth available in the first FPGA DDR4 SDRAM used by the FPGA AI Suite IP and AI related functions.

The main buffer is also used to rate match the output to input frame rates, such that an output frame can be repeated if the input frame rate is too slow, or an input frame can be dropped (deleted) if the output frame rate is too slow. Note that the sensor ingest cannot accept any sufficient back-pressure. All rate matching must be done using complete frames and on frame boundaries. The AI Stream Controller is used to control the Main Frame Buffer.


AI Input

The AI Input is used to format the 4K ISP output image into a suitable format and store it away for the FPGA AI Suite IP to read.


ai_input.

AI Input


A VVP Pixel Adapter is first used to drop the 10-bit color depth input image down to 8-bit color depth. A VVP Scaler IP is then used to down scale the 4K image to a 640x384 image suitable for the inference models supported.

The Scaler output feeds into the non-QPDS Layout Transform (LT) IP (supplied with the source project). This IP, along with a 2 line store FIFO, is used to convert the raster scan video input format to the vectorized data format required by the FPGA AI Suite IP (complete with required pixel and line padding). In addition, the LT IP folds multiple input pixels into the vectorized data to increase the compute efficiency of the first convolution layer in the FPGA AI Suite IP. The LT IP function is summarized in the following diagrams.

The first diagram illustrates an example 8-bit color depth input image received as 24-bit pixel values in Raster Scan format (left to right, top to bottom):

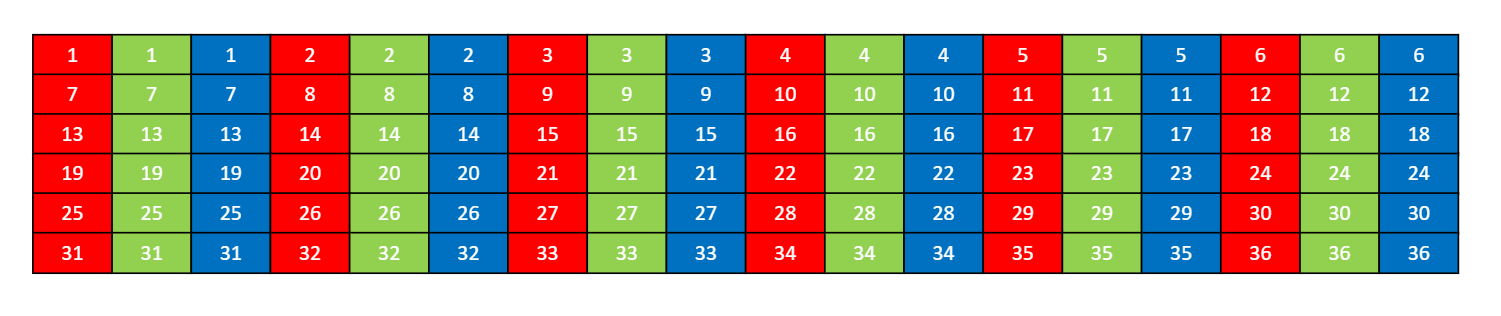

LT_input.

Example 6x6 resolution 8-bit RGB input image


The next diagram illustrates the same example image framed with 1 mid-gray line above and below and 1 black pixel before and after, and the 2x2 convolution stride that will be applied:

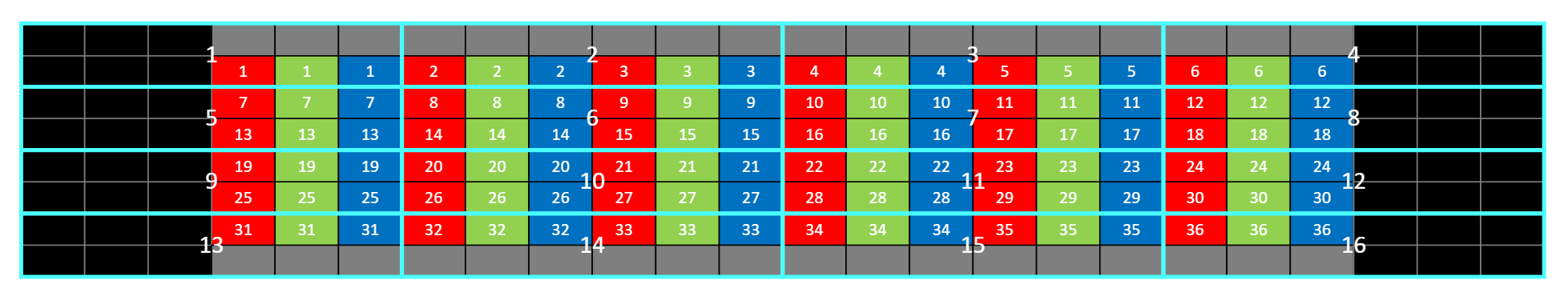

LT_input_padding.

Example 6x6 resolution 8-bit RGB input image with padding and 2x2 convolution stride highlighted


The unsigned 8-bit integer (uint-8) RGB values are each converted to 11-bit floating point (FP11) format and each packed into 16-bits. The final diagram illustrates the 2x2 convolution stride applied to the padded input image along with a CVEC = 16 line length to form the 256-bit output words (16 values * 16-bits). Note that the last 4 16-bit values of each output word are unused as the input image only contains 3 color planes. However, even with this wastage, folding 4 pixels into each output word gives a good performance boost for the first convolution.

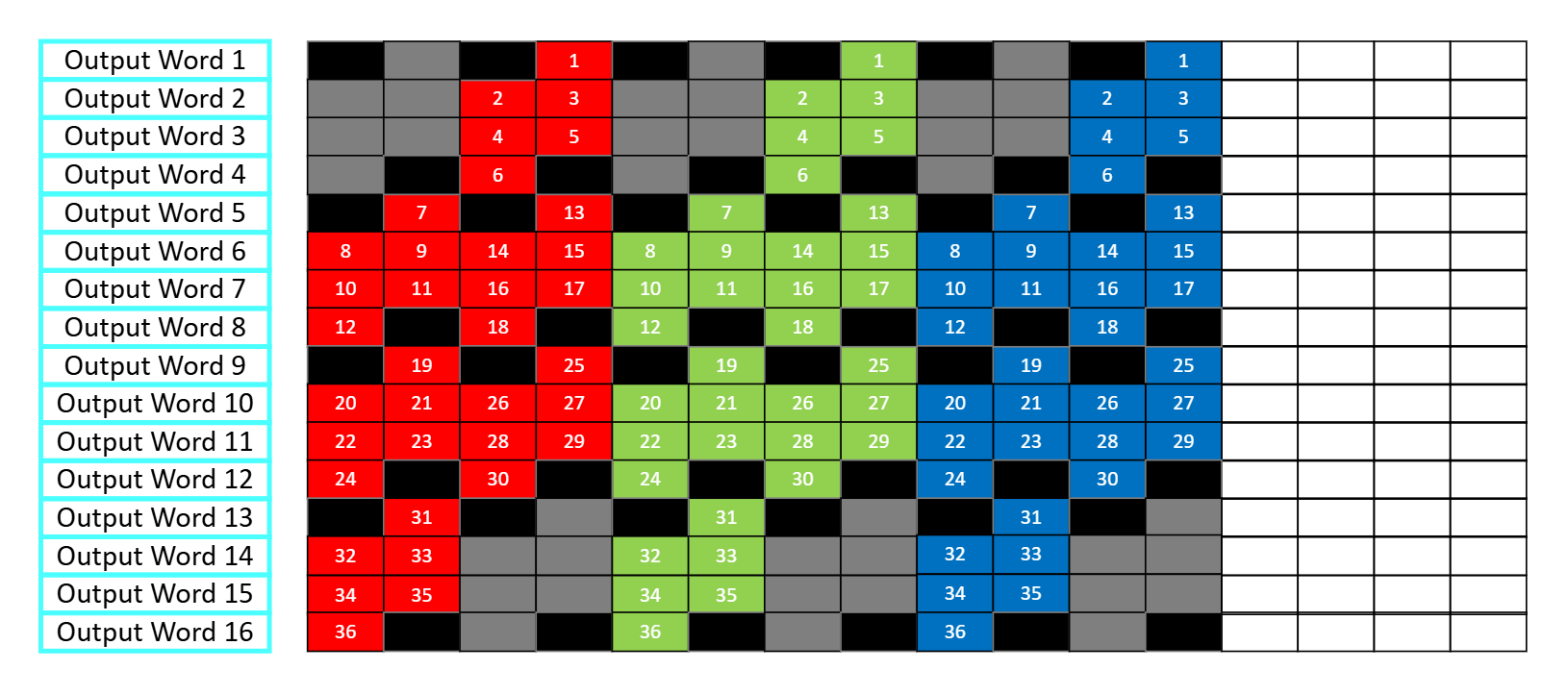

LT_output.

Example 6x6 resolution padded FP11 RGB input image vectorized using 2x2 convolution stride and CVEC = 16


A VVP Frame Writer IP is then used to store the vectorized output data words into buffers in external DDR4 SDRAM (via an EMIF). Buffers are used to support rate matching of AI inference rates vs input and output frame rates. For instance if the AI inference is too slow, then input images can be dropped. Note that the sensor ingest cannot accept any sufficient back-pressure. All rate matching must be done using complete frames and on frame boundaries.

The inference models actually support a square input image and not the 16:9 widescreen image format supported by the input sensor and output Monitor i.e. the image read into the FPGA AI Suite IP needs to be square. Different approaches can be taken to address the aspect ratio mismatch. One approach is to distort the widescreen images into square images, but this would require the models to be retrained. An alternative solution is to crop a square image from the widescreen image. But where to crop from - left, right, center? There will always be an area missing in the inference results. The solution used in this design is to letterbox the widescreen image after the down scale to effectively make it square and therefore introduce no distortion. This is easily achieved by adding extra padding lines above and below the image (in order to keep it centralized). The downside to the letterbox approach is lower accuracy results, which is simply due to the smaller size of the actual real image (as padding makes up a proportion of the square image). The inference models expect a square 640x640 input image, and so the down scaled 640x384 widescreen image is stored into the DDR4 SDRAM buffer with an extra 256 padding lines - 128 lines above and below the image. Since the padding never changes, the SW App pre-fills the FPGA AI Suite IP buffers in external DDR4 SDRAM with padding lines at initialization. The Frame Writer IP then writes the down scaled images to the same buffers but offset by 128 lines. In reality, the output of the LT IP already has 1 padding line above and below the down scaled image as part of the input requirements into the FPGA AI Suite IP, and so the offset is actually 127 lines and the overall image size is 2 lines larger.

The AI Stream Controller is used to control the AI Input.

Related Information

Scaler IP
Video Frame Writer IP
EMIF


AI

The AI performs the actual inference and uses the FPGA AI Suite IP - a configurable AI engine IP. It has Avalon® memory-mapped interfaces for both control and status, and external DDR4 SDRAM access (via EMIF). The IP is configured using parameters defined in an Architecture Description File (.arch file). The main parameters define:

  • Processing Element (PE) Array Vectorization
  • Scratch Pad Sizing
  • External memory bus bandwidth
  • Types/vectorization of auxiliary layer blocks


Defining the architecture depends on the model, desired performance, and resource utilization.

In the case of the Camera with AI Inference Solution System Example Design, the Ultralytics YOLOv8 nano PyTorch models are firstly manipulated using ONNX to ensure compatibility with the FPGA AI Suite IP. This involves converting to ONNX oppset 11 and chopping the network head off using onnx.utils.extract_model. ONNX is converted to OpenVINO IR (intermediate representation) .xml and .bin files using the OpenVINO Converter (OVC). The FPGA AI Suite Compiler takes the OpenVINO IR files, along with the .arch file and produces a compiled .bin file which represents the instructions required by the IP. The SW APP uses the .bin file to generate the runtime Config for the IP.

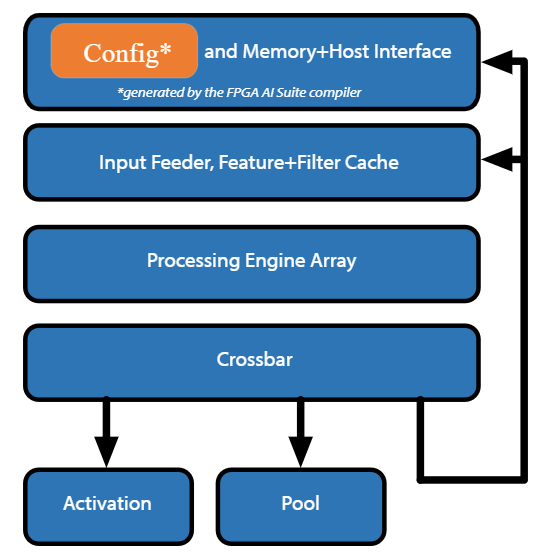

fpga_ai_suite_ip.

FPGA AI Suite IP


The generic .arch file supplied with the AI Suite install (\opt\altera\fpga_ai_suite_2025.1\dla\example_architectures\AGX5_Generic.arch) is used initially. The .arch file is then optimized using knowledge of the model (like removing unused activation functions), and using the FPGA AI Suite Compiler's area and performance estimator tools.

The FPGA AI Suite IP reads the vectorized data image from the buffers in external DDR4 SDRAM (via an EMIF). It performs the inference and writes back the inference results to the external DDR SDRAM. The HPS reads the inference results for further processing.


ai.

AI



AI Output

The AI Output is used to read the 960x540 (quarter HD) sized ARGB2222 (4 2-bit color channels - Alpha, Red, Green, and Blue) inference result overlay image and scale it up to 4K ARGB10101010 ready to be mixed with the AI Main Frame Buffer output (the delayed 4K ISP output).


ai_output.

AI Output


The AI Output is generated using an external DDR4 SDRAM (via an EMIF), a VVP Frame Reader IP, and a VVP Scaler IP. For every input image with inference results, the AI Stream Controller generates a 960x540 (quarter HD) sized ARGB2222 inference result overlay image and stores it in the Overlay Output Buffer in external DDR4 SDRAM. When instructed by the AI Stream Controller, the VVP Frame Reader IP reads an inference result overlay image from the Overlay Output Buffer. It is passed on to a VVP Scaler IP which up scales it to 4K. This 4K ARGB2222 inference result overlay image is then converted to ARGB10101010 (4 10-bit color channels - Alpha, Red, Green, and Blue) before being passed on to be video mixed with the 4K ISP output image - which has been delayed through the AI Main Frame Buffer to align correctly.

Related Information

Video Frame Reader IP
Scaler IP
EMIF


AI Stream Controller

The AI Stream Controller is used to synchronize the Main Frame, AI Frame, and Overlay Output Buffers to the FPGA AI Suite IP inference and results. The AI Stream Controller is a software based design consisting of two parts, the Stream Controller Application that runs on a Nios® V soft CPU, and the Stream Controller Comms, which is a library within the runtime of the HPS SW App.

Communication between the CPUs is achieved using interrupts (driven via PIO registers) and a shared Message Queue which is constructed using an on-chip DPRAM accessible to both CPUs. Using the interrupts from the FPGA AI Suite IP and all of the VVP Frame Writer and Frame Reader IPs, the Stream Controller can orchestrate inferences, read inference results, build inference result overlays, and track images through the different buffers.


Output Processing

This section summarizes notable output processing functions and IPs used in the Camera Solution System Example Design:

Video Mixer

The Video Mixer is used to combine the different input images into a single output image. It uses a VVP Test Pattern Generator IP, a VVP Mixer IP, and a non-QPDS Icon IP (supplied with the source project).

The TPG (Instance 1) is the base layer for the Mixer IP. It is configured by default as a 4K solid black image which also serves as the screensaver function. The TPG also supports color bars, which can be used to test the DP output.

The base layer is mixed with the AI Main Frame Buffer output image (ISP output image), the inference result overlay image, and the Altera® logo overlay image. The opacity of the inference result overlay image is controlled on a per-pixel basis and is set by the AI Stream Controller when it constructs the image. The opacity of the Icon overlay is globally controlled and can be changed during runtime by the SW App.

Related Information

Test Pattern Generator IP
Mixer IP


1D LUT

The 1D LUT IP uses a runtime configurable LUT to apply an input output transfer function to the image. You may use it to implement OOTF, OETF, and EOTF transfer functions defined for video standards and legacy gamma compression or decompression. You may also change the LUT content arbitrarily for other transfer functions or to apply an artistic effect to the image.

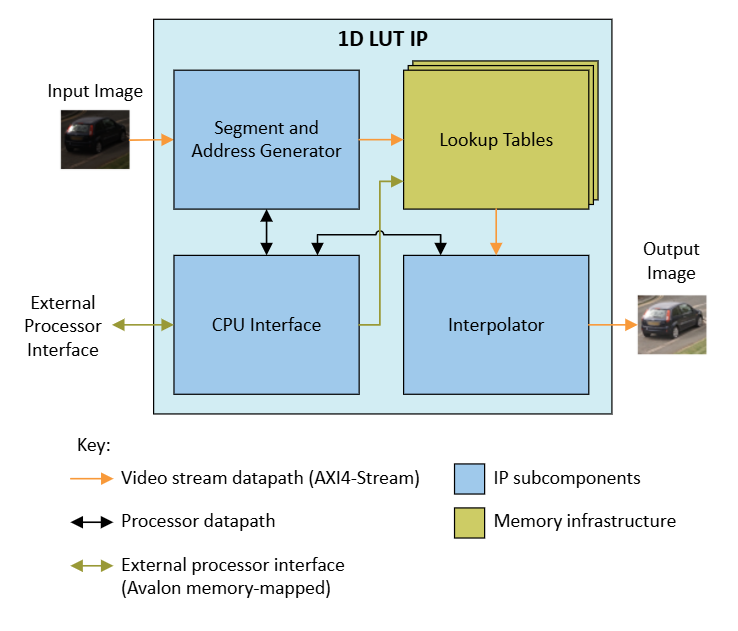

1DLUT_diagram.

1D LUT Block Diagram


The 1D LUT IP calculates LUT addresses from the input pixels. It interpolates fractional differences between LUT values to generate output pixel values. The IP uses an independent LUT for each color plane. The SW App uses the Avalon® memory-mapped interface to configure the LUTs.

In this instance, the 1D LUT is used for traditional Gamma, High Dynamic Range Perceptual Quantizer (HDR PQ) and Hybrid Log-Gamma (HDR HLG) correction. The 1D LUT is configured as a 9-bit LUT and the output is increased to 12-bits to support the Capture Switch that follows.

Related Information

1D LUT IP


Frame Capture

The Frame Capture function uses a two VVP Switch IPs and a VVP Video Frame Writer IP which is connected to an external FPGA DDR4 SDRAM memory (via an EMIF).

The Video Frame Writer IP operates in a single shot mode on RGB 12-bit images.

The Capture Switch (VVP Switch IP - Instance 5) is used to feed the Video Frame Writer with either the raw sensor image via the Raw Capture Switch (VVP Switch IP - Instance 4) or the ISP output image via the 1D LUT IP (Instance 0). The raw sensor image uses a single color for each pixel and so a VVP Color Plane Manager IP is used to copy the single color into all 3 color planes to generate a grayscale RGB raw sensor image for capture.

The HPS has a host Avalon® memory-mapped interface to the FPGA external DDR4 SDRAM, allowing it to read out the captured image.

The output of the Capture Switch when not feeding the Video Frame Writer IP, feeds the output image to the DP output via a VVP Pixel Adapter IP to reduce the color bit depth back down to 10-bits.


ISP Egress

The ISP Egress is used to interface the final AI ISP 4K output to the multi-rate DP IP. The following output resolutions and color bit depths are supported by the Camera Solution System Example Design:

  • 4Kp30 @ 8/10-bit RGB color
  • 1080p30 @ 8/10-bit RGB color
  • 720p30 @ 8/10-bit RGB color

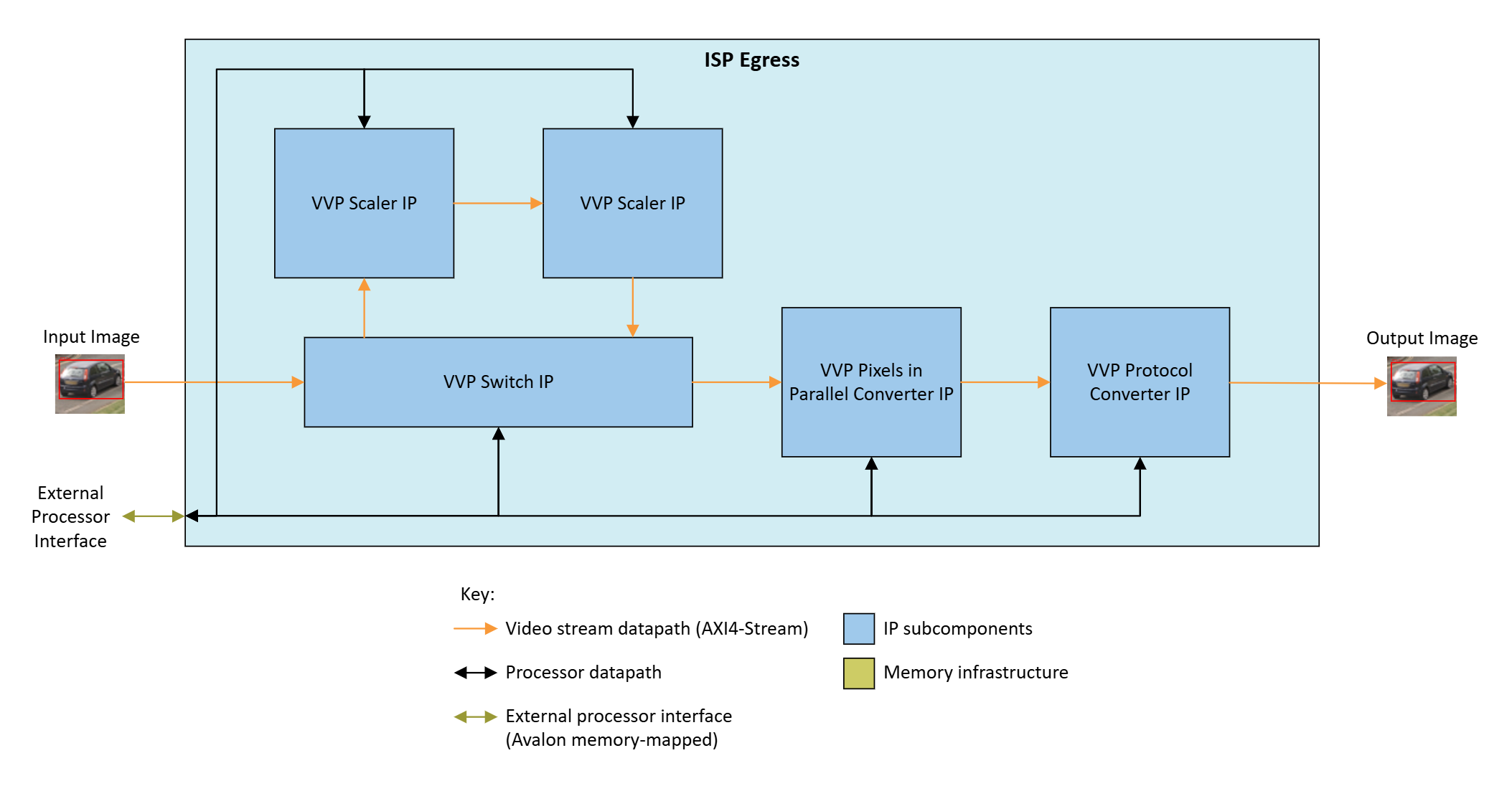

dp_output.

ISP Egress


For 4K output, the VVP Switch IP bypasses the VVP Scaler IP and simply passes the input to the output. To support 1080 and 720 resolutions, the 4K input is down scaled using the Scaler. Although not explicitly shown, two Scalers are used back-to-back. The first (instance 2) down scales the horizontal resolution while the second (instance 3) down scales the vertical resolution. Using two Scalers in this way reduces the Scaler on-chip memory resource by half.

Since the DP IP does not support 1 PiP or the VVP AXI4-S Lite protocol, the output from the switch is passed through a VVP PiP Converter IP followed by a VVP Protocol Converter IP.


DP Egress

The DP Tx function is provided by the Altera® DisplayPort connectivity IP.

It is configured to support DisplayPort 1.4 (x4 lanes of 8.1 Gbps, sufficient for 4Kp30 10-bit RGB). The DP IP also supports the VVP AXI4-S Full protocol interface.


Hard Processor System

Hard Processor System (HPS) runs the Software Application that configures the external optical sensor module and the internal IPs, and provides the AI functionality and various camera control loops such as AWB and AE. In addition, it runs a web server that allows you to interact with the design demonstration via an Ethernet connection. The HPS has its own external DDR4 SDRAM that is used exclusively by the software stack.

The HPS is also connected to the external FPGA fabric DDR4 SDRAM/s to process data for the AI and frame capture functions. In addition, the HPS has access to the Modular Scatter-Gather Direct Memory Access IP (mSGDMA). This IP can be programmed by the HPS to offload memory copy functions between HPS and FPGA external DDR4 SDRAM/s.

Related Information

mSGDMA IP


Additional Reference Information



Back


Last update: July 9, 2026
Created: December 10, 2025
Ask in the Forum
